Marine logistics coordination for offshore EPC projects means keeping several moving jobs tied to the same project plan.
One vessel is waiting on cargo release. Another is holding for berth confirmation. A third has an agent chasing customs, transport, and a revised PO. Chartering is working from one ETA, the terminal has another, and the offshore team wants to know which arrival time they can safely plan around.
That is what the job feels like most days.
One local change can move loading, sailing, offshore arrival, vessel hire, crew planning, and the next installation activity. The logistics lead has to work out what changed, who needs to act, and how far the effect has already travelled through the project.
This guide looks at how that coordination runs, where the handoffs tend to fail, and what a principal needs to see across multiple ports and appointed agents.
How Marine Logistics Coordination Works Across an Offshore EPC Project
The movement starts with a project need.
Something has to get from one place to another by a date that matters. It might be fabricated equipment, subsea hardware, cable, tooling, spares, or specialist personnel.
From there, several teams take ownership of different parts of the job.
Project Logistics Defines the Movement
Project logistics starts with the work package.
The team needs to know what is moving, where it is coming from, how it can be handled, when it will be ready, and what offshore activity depends on its arrival.
This is where vague timing causes trouble later.
“Cargo ready Monday” could mean fabrication wraps up on Monday. It could mean the cargo leaves the yard on Monday. It could also mean the cargo is at the loadout point, cleared, documented, and ready for the vessel.
Those are three different plans.
Someone has to challenge the date and ask what “ready” actually means.
The answer affects the vessel window, inland transport, customs, lifting support, terminal timing, and offshore sequence.
Once that picture is clear, chartering can work with something real.
Chartering Fixes the Vessel
Chartering takes the movement requirement and secures the vessel.
They are looking at availability, commercial terms, expected duration, routing, hire exposure, and the working window.
Once the vessel is fixed, the schedule can start to look settled.
That is usually when the rest of the open items become more obvious.
The cargo may still be inside the fabrication yard. The berth may be provisional. Customs may need more information. A crane contractor may still be holding the old window. The agent may be waiting on the final scope.
The vessel is fixed, but the movement still has work to do.
This handoff needs more than a vessel name and ETA. Project logistics needs the actual commercial and operating constraints around the fixture, especially the ones that can add time or cost.
Those details then need to reach the local agent before they become a port problem.
The Principal Appoints the Local Agent
The appointment is where the project plan turns into a local job.
A good appointment tells the agent what the vessel is doing, what the cargo operation involves, which services are required, which milestones matter, how often updates are expected, which costs need approval, and who to call when the plan moves.
The agent also needs enough context to understand why the timing matters.
Knowing that loading must finish by midnight is useful. Knowing that a later sailing pushes the vessel outside an offshore lifting window is much more useful.
That context helps the agent decide what needs attention first.
It also gives them a reason to escalate early rather than report the delay after the window has already gone.
The Agent Builds and Maintains the Local Plan
Once appointed, the agent starts pulling the local job together.
They are dealing with the port, terminal, customs, transport providers, pilots, tugs, line handlers, launch boats, security teams, cargo contractors, hotels, crew transport, and specialist vendors.
Then the plan starts moving.
The ETA changes. The terminal adjusts the sequence. Customs asks for one more document. A vendor says the revised window no longer works. A PO needs to be changed. The cargo is released later than expected.
The agent has to keep the local plan current while making sure the right people are working from the latest instruction.
That is where the quality of the coordination setup becomes obvious.
An agent can be doing solid work on the ground while the principal still has poor visibility because the updates are sitting in separate threads.
A shared record such as Base Connect keeps the conversation, files, and updates tied to the relevant Job or Project, so the working group is not relying on forwarded emails to piece together the call.
The local update still needs one more step. Someone has to connect it back to the project.
The EPC Team Interprets the Project Effect
The agent reports what is happening in the port.
The EPC team has to decide what it means for the rest of the job.
A customs issue may move cargo release. A later cargo release may move loading. A later loading completion may move sailing. A revised sailing time may affect offshore arrival, vessel hire, crew readiness, or the next work package.
That connection is the part that matters.
A local update becomes useful once the project team can see the schedule and cost consequence attached to it.
When that link is missing, the same control problems keep showing up.
Where Control Breaks Across Multiple Ports and Agents
Most multi-port projects run into the same five issues.
- Every agent reports differently: One agent says a call is ready when the berth and vessel are confirmed. Another waits for cargo, customs, vendors, and documents. A third uses “ready” once the vessel is alongside. The principal sees the same label and gets three different situations.
- Changes reach part of the group: Chartering sends a revised ETA. The agent updates the berth request. The transport contractor is still working from the earlier window. Project controls update the schedule. Finance keeps the original estimate.
- Approvals live away from the work: A vendor quote is approved in one email. The service is booked in another. The PO comes later. The scope changes during the call. Now someone has to work out what was approved, what changed, and which amount still applies.
- The team adds more trackers: First comes the vessel tracker. Then the port-call tracker. Then the cost file, risk register, and management summary. Each one answers a specific question. Each one also creates another place where the current position can fall behind.
- The principal gets updates without getting a usable view: Reports arrive from every port. Someone still has to compare the timestamps, spot the missing approval, check the cost position, and decide which movement needs attention.
This is where agent-by-agent email coordination becomes the actual bottleneck.
The project logistics team spends too much time assembling the picture and too little time dealing with the issue in front of them.
A common control model cuts through that.
The Seven Control Points for Multi-Port EPC Marine Logistics
The Seven Control Points give the principal a consistent way to review every movement, no matter which agent or port is involved.
Each one needs an owner, a current status, a timestamp, a supporting record, a project dependency, and a clear escalation path:
Control Point 1: Movement Intent
Every movement needs a clear project purpose.
What is the vessel carrying? Which work package does it support? When does the cargo need to reach the field? What happens if it arrives late?
That context sets the priority.
A routine personnel transfer can absorb more movement than a vessel carrying equipment needed for a fixed installation sequence.
The agent does not need the entire EPC plan. They do need the timing and dependency that shape the local decisions.
Control Point 2: Appointment Control
The appointment should make the agent’s responsibility clear.
It needs to cover the local scope, required services, reporting cadence, approval limits, document requirements, and escalation contacts.
A common appointment format gives the principal a fair basis for comparing agents across ports.
It also gives the agent a cleaner start.
Control Point 3: Readiness Control
Readiness has to be broken down.
The vessel may be ready while the cargo is still inside the yard. Cargo may be ready while customs is waiting on a document. Customs may be complete while the berth remains unconfirmed.
A single green status hides too much.
The team needs to see exactly what is holding the movement and who owns the next action.
That is the difference between a useful readiness view and a status light that tells you very little.
Control Point 4: Change Control
Every material change needs a record.
The team should be able to see the old plan, the new plan, when the change happened, who was affected, what changed locally, and what it means for the project.
A revised ETA is only useful when the vendor bookings, approvals, cargo activity, and schedule milestones connected to it are also updated.
Change control gives the team one current position to work from.
Control Point 5: Execution Control
Every agent should use the same milestone definitions.
Arrival, all fast, cargo start, cargo complete, clearance complete, pilot ordered, sailed, and closed should mean the same thing across the project.
That saves the principal from interpreting every report.
It also gives the team a reliable basis for comparing calls.
Control Point 6: Cost Control
The money trail should stay with the movement.
The PDA, vendor quote, approval, PO, accrued amount, invoice, payment status, and final variance need to sit in one chain.
That matters most when the call changes.
A berth delay can add tug, launch, transport, labor, or vessel-hire exposure. The team needs to see which costs were expected, which were approved, and which appeared after the plan moved.
A dedicated port cost management record keeps operations and finance on the same call-level position.
Control Point 7: Project Impact Control
Every material event needs to show what it does to the wider EPC plan.
A later berth time may move cargo completion. A later cargo completion may move sailing. A revised sailing time may change offshore arrival, vessel hire, crew deployment, or the next work package.
The record should show the event, the local effect, the schedule consequence, the added cost, and the decision that followed.
That is the point where a port update becomes something the project team can act on.
How Local Port Events Affect the EPC Schedule
Take a customs hold on fabricated equipment.
The agent learns that clearance will finish 14 hours later than planned. Cargo release moves. The terminal shifts the loading slot. The vessel stays alongside longer. Sailing moves into the next workable window. Offshore arrival now falls inside a tighter weather period.
The original issue was customs.
The project effect now includes vessel hire, berth time, labor, transport, and the offshore installation sequence.
That full chain needs to stay visible:
Local event → port consequence → vessel consequence → offshore consequence → cost consequence
A delay entry that says “customs issue” does not give project controls enough to work with.
They need to know when it started, which milestone moved, how much time was lost, what cost changed, and what decision followed.
The wider shipping market gives some context for the amount of timing uncertainty marine teams deal with. Lloyd’s List reported that global container schedule reliability was 51.5% in October 2024, while late vessels arrived an average of 5.72 days behind schedule. Offshore EPC work runs differently, though the figures still show how quickly marine timing can move away from the original plan.
The project team also needs to review timing alongside completion.
A vendor can finish the assigned work after the required window has passed. A port call can close with every local service complete while the vessel still reaches the field too late for the planned activity.
The question that matters is straightforward:
Did the port execution protect the project requirement?
Across several ports and agents, that answer needs to be visible without another round of calls.
What the Principal Needs Across the Full Marine Campaign
The principal needs one current view across every active movement and appointed agent.
At a glance, the project logistics lead should be able to see the vessel, port, agent, current stage, last update, next milestone, open readiness item, pending approval, forecast cost, and schedule exposure.
That view should make the gaps obvious.
Which agents have missed an update? Which calls are waiting on principal approval? Which movements have growing cost exposure? Which ports keep producing the same customs or vendor issue? Which vessel carries the greatest schedule risk?
Those are the questions that matter during the campaign.
The principal also needs to open the record behind the status.
If a movement is marked at risk, the latest agent update, vendor quote, approval, PO, document, cost entry, and schedule change should all be there.
That gives management a defensible answer when someone asks why the movement is late or over budget.
It also gives the principal a better way to review agents.
Reporting discipline, readiness performance, cost variance, exception handling, and closeout quality can be compared using actual calls rather than memory.
For projects involving mobilization, marine spreads, installation support, and port activity, marine construction software should tie every movement back to the work package it supports.
For broader energy programs, oil and gas logistics software should give the principal a current operational and financial view across the campaign.
That is the kind of view Base is built around.
How Base Gives EPC Principals Control Across Multi-Port Marine Logistics
Base gives the EPC team a project view across the campaign, with a detailed Job record behind each local movement.
✓ Projects connect the campaign: A Project groups the vessel movements, port calls, appointed companies, costs, files, and related work tied to the same offshore scope. The project logistics lead can review the full campaign and open the detail behind any call.
✓ Jobs hold the live movement record: Each port call can have its own Job containing the vessel, port, dates, assigned companies, services, charges, approvals, invoices, files, and activity history.
✓ Company and contract records keep the commercial context attached: Agent, vendor, and client details remain available across the project. Agreed rates and contract terms can be linked to the relevant work, which helps when several ports and counterparties are involved.
✓ Permissions support cross-company coordination: Principals can give agents, vendors, and internal teams access to the information they need for the job. Internal commercial records can stay restricted.
✓ Accounting stays tied to execution: Quotes, purchase orders, expenses, invoices, payables, receivables, and job-level financials stay with the movement that created them. Finance can review the source call without reconstructing the trail.
✓ Documents and activity stay with the work: Updates, approvals, attachments, and status changes stay connected to the relevant Job or Project. Project controls, finance, management, and claims teams can review the operating history when questions come up.
For the principal, the value is practical.
They can see which movement needs attention, which agent is waiting on a decision, where the cost position changed, and what record supports the current status.
That gives the project team better information to work with now and better data to use on the next call.

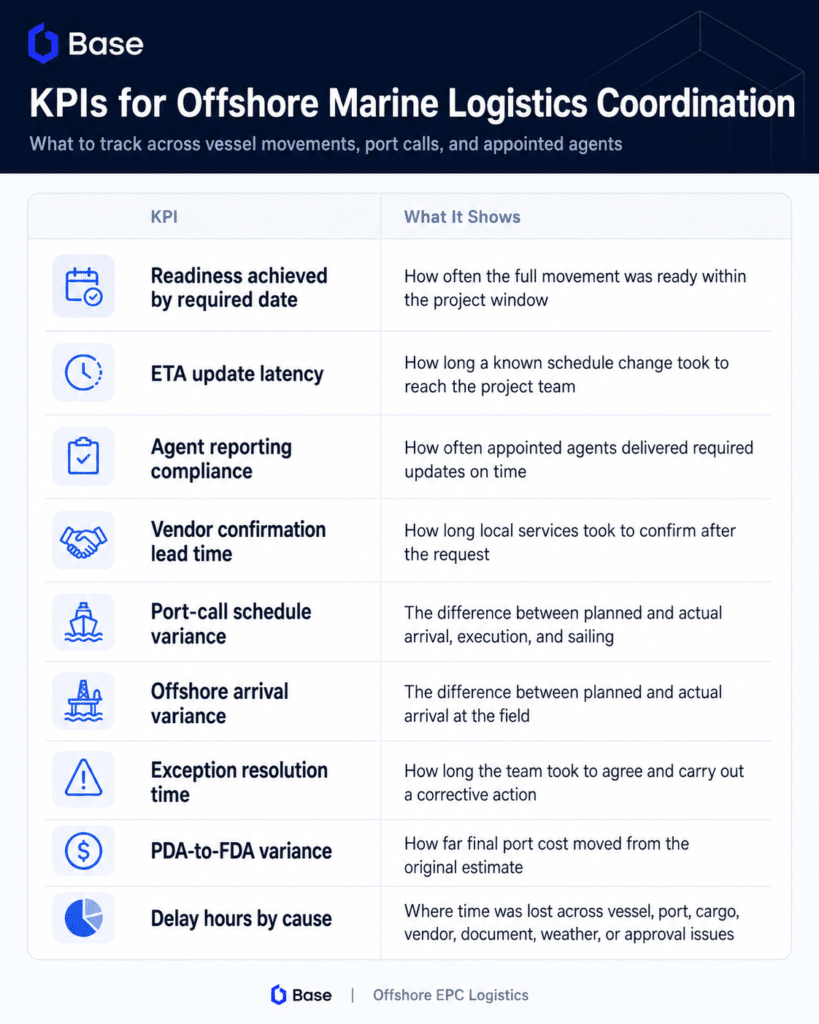

KPIs for Offshore Marine Logistics Coordination
The useful KPIs are the ones that show whether local execution supported the offshore schedule.
These numbers only work when every agent uses the same definitions.
“Ready,” “confirmed,” “delayed,” and “closed” need the same meaning across the project. Milestone timestamps and exception categories need to be applied the same way.
Once that is in place, the principal can see where delays keep showing up, which ports need more lead time, which agents report well, and where cost variance keeps creeping in.
That information should feed the next appointment, the next movement plan, and the next project review.
Conclusion: Marine Logistics Coordination for Offshore EPC Projects
Marine logistics coordination for offshore EPC projects sits between the vessel plan and the offshore workfront.
Project logistics defines the movement. Chartering secures the vessel. The local agent builds the port plan. Vendors carry out the work. Finance follows the cost. Project controls track the schedule effect.
The job is keeping those teams on the same current position.
The Seven Control Points give the principal a common way to manage movement intent, appointments, readiness, changes, execution, cost, and project impact.
Base gives the project team a campaign-level view with the source record behind every movement.
That creates cleaner handoffs, faster decisions, better cost records, and fewer hours spent working out which version of the call is current.
Key Takeaways
- Marine logistics coordination keeps vessel movements, port activity, local agents, vendors, approvals, costs, and offshore milestones tied to the same project plan.
- Control often breaks during handoffs, especially when agents, chartering, project controls, finance, and vendors work from different records.
- A common control model helps principals track movement intent, appointments, readiness, changes, execution, costs, and project impact across every port.
- Local port issues can affect loading, sailing, offshore arrival, vessel hire, crew planning, and the next installation activity.
- Base gives EPC principals a project-level view of the marine campaign with a detailed operating and financial record behind each movement.
Frequently Asked Questions
What is marine logistics coordination for offshore EPC projects?
Marine logistics coordination for offshore EPC projects is the work of keeping vessel movements, port calls, cargo, agents, vendors, approvals, documents, costs, and offshore milestones tied to the same project plan. It gives the project team a current view of each movement and the effect it may have on the wider construction schedule.
Where does marine logistics control usually break?
Control often weakens during handoffs between project logistics, chartering, local agents, vendors, finance, and project controls. Separate reporting formats, missed ETA updates, disconnected approvals, and stale trackers make it harder for the principal to see the current position across multiple ports.
What should an EPC principal track across appointed port agents?
The principal should track movement readiness, reporting timeliness, open exceptions, pending approvals, forecast costs, schedule exposure, and the next critical milestone. Each status should link back to the local records, including agent updates, vendor quotes, purchase orders, documents, invoices, and approvals.
How can a local port issue affect the offshore project schedule?
A customs hold, berth change, late vendor, or cargo delay can move loading and sailing times. The revised sailing time may affect offshore arrival, vessel hire, crew planning, weather exposure, and the next installation activity. The movement record should show that full chain of impact.
